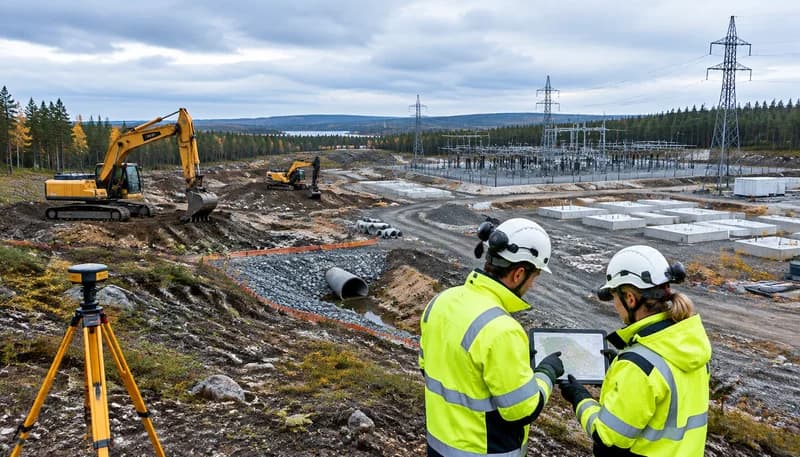

The New Failure Mode in Hyperscale Delivery: Environmental Impact Assessment (EIA) Halts Ahead of Substation Delivery
In contemporary hyperscale campus delivery, project controls frequently center on the electrical critical path: High-Voltage (HV) transmission interconnection agreements, transformer manufacturing cycles, and regional grid capacity allocations. However, an emerging failure mode demonstrates that resolving the power equation does not insulate capital programs from catastrophic regulatory halts. When Fingrid confirmed transmission headroom for multi-gigawatt loads in northern Finland, long-lead power procurement appeared solved. Yet, the delivery pipeline ground to an abrupt halt when municipal civil preparatory packages outpaced environmental licensing, triggering statutory stop-work directives from the Finnish Licensing and Supervisory Authority (LVV).
The fundamental systemic vulnerability lies in treating high-voltage grid queue maturation as the primary gating item for civil groundbreakings. Program managers often compress civil schedules by authorizing advance bulk earthworks, access roads, and staging areas under secondary permits (such as standard silvicultural clearing notices) while the overarching Environmental Impact Assessment (EIA) remains in draft status. This misaligned sequencing converts standard land-clearing into an irreversible civil alteration, directly violating European Union and Nordic statutory EIA mandates and prompting regulatory stays that freeze site capital expenditure for multiple calendar quarters.
Establish formal stage-gates preventing bulk earthworks until the EIA Administrative Record of Decision is legally non-appealable.
Perform integrated schedule risk audits linking Transmission System Operator (TSO) interconnection milestones with civil zoning compliance.
Implement real-time regulatory compliance telemetry to track stop-work risk across cross-functional civil-electrical procurement tracks.
Statutory Land Alteration Thresholds: 200+ Hectare Logging, Topsoil Stripping vs. Pre-Approval Field Surveys
Under Finnish statutory frameworks and broader EU Environmental Impact Directives, project scale dictates the jurisdictional boundary between exempt preparatory surveying and mandatory environmental impact review. Standard silvicultural harvesting operated under the Forest Act permits commercial timber extraction, but this exemption collapses when the clearing is executed in anticipation of industrial land use. In the recent regulatory intervention, logging operations spanning approximately 330 hectares at Muhos and nearly 200 hectares at Kajaani crossed the statutory threshold where land alteration ceases to be timber management and becomes de facto industrial site formation.
The technical dividing line enforced by regulatory bodies separates non-invasive, reversible geotechnical investigative actions from permanent topsoil stripping, stump extraction, and surface grading. Non-invasive activities—such as seismic refraction lines, core penetrometer testing, discrete borehole drilling, and ecological mapping—preserve the in-situ soil stratigraphy and ground cover. Conversely, clearing mature taiga canopy and stripping the organic peat or till horizon irrevocably alters surface albedo, microclimates, and hydrologic profiles, legally establishing that industrial construction has commenced regardless of foundation pouring status.
Maintain pre-approval civil activities within strictly non-invasive boundaries (e.g., core drilling < 150 mm diameter, localized clearing pads < 25 m²).
Enforce a hard zero-topsoil-stripping rule across campus boundaries prior to statutory EIA public consultation closure.
Delineate clearcut timber operations under an independent third-party forestry management plan with no direct structural connection to data hall pads.
Civil Sequencing Conflict: Why Fast-Track Groundbreakings Invalidate EIA Alternative Baselines and Habitats
The statutory purpose of an Environmental Impact Assessment is to establish an empirical, pre-development environmental baseline against which project alternatives, ecological degradation, and mitigation strategies can be quantified. When EPC contractors initiate early timber felling across hundreds of hectares, they eliminate the counterfactual baseline required by administrative law. At Muhos, clearing 330 hectares of boreal forest eliminated the existing habitats of local avifauna, saproxylic beetles, and sub-arctic vegetation, preventing regulatory ecologists from assessing baseline biodiversity conditions during spring and summer field seasons.
From an administrative law standpoint, clearing the site prior to permit issuance legally prejudices the assessment of layout alternatives. An EIA is obligated to analyze multiple master-plan configurations, including alternative data hall footprints, substation alignments, stormwater routing, and a mandatory 'zero-alternative' (no-build scenario). If civil contractors pre-clear the entire site to optimize a single, preferred engineering layout, the statutory review process is rendered moot, exposing the project to fatal legal challenges from regulatory bodies and non-governmental organizations that can invalidate future building permits.
Protect at least three viable layout alternatives in undisturbed conditions until formal regulatory baseline validation occurs.
Schedule multi-season ecological surveys (minimum 12-month cycle) prior to issuing early contractor involvement (ECI) civil mobilization notices.
Document continuous flora, fauna, and soil chemistry baselines with third-party accredited environmental auditors to prevent evidentiary loss.
Water Basin, Peatland Hydrology, and Drainage Permitting in Nordic and Sub-Arctic Topographies
The geography of northern Finland presents distinct hydrogeological vulnerabilities dominated by shallow water tables, sensitive peatland (sphagnum bogs), and glacial moraines overlying crystalline bedrock. Rapid deforestation of 200 to 300 hectares immediately eliminates vegetative evapotranspiration, which in boreal forests accounts for up to 50% of summer precipitation dissipation. This disruption elevates the local groundwater table, inducing hydrostatic pressures that destabilize surrounding peat massifs and substantially increase surface runoff coefficients ($C$-values rising from $0.15$ in native forest to $>0.60$ on stripped mineral soil).
Furthermore, unpermitted ditching and drainage operations mobilize suspended solids, humic acids, and potentially acidic runoff from sulfur-rich subsoils into regional river basins. Sub-arctic aquatic ecosystems are extremely sensitive to siltation and pH fluctuations. Initiating drainage network engineering without dedicated, engineered stormwater attenuation basins—designed to retain 1-in-100-year storm events and limit discharge rates to pre-development levels—violates both the Finnish Water Act and the EU Water Framework Directive, providing immediate technical grounds for municipal building-control authorities to halt all grading.
Deploy temporary sedimentation ponds and geotextile check dams to maintain total suspended solids (TSS) discharge below 30 mg/L during all site preparations.
Model pre- and post-clearing hydrological regimes using continuous-simulation software to account for snowmelt and peatland drainage dynamics.
Acquire standalone Water Act permits for all dewatering and ditching installations before mobilizing heavy civil machinery.
Decoupling Grid Allocation from Civil Authorization: Dual-Track Permitting Architecture for Gigawatt Campuses
To prevent schedule collisions between grid procurement and environmental compliance, infrastructure developers must transition from serialized Critical Path Method (CPM) networks to a decoupled, dual-track program architecture. Track A encompasses electrical capacity allocation, high-voltage substation engineering (400 kV/110 kV), and TSO interconnection agreements. Track B governs land acquisition, municipal zoning (Asemakaava), and comprehensive environmental licensing. These tracks must be decoupled so that delays or long assessment horizons in Track B do not accelerate unpermitted civil work simply to match Track A lead times.
Under a decoupled framework, grid capacity reservation milestones must not be contractually dependent on irreversible site clearance deadlines. Developers should negotiate flexibility provisions within their Connection Agreements with TSOs like Fingrid, enabling substation pad construction to proceed within a tightly controlled, ring-fenced utility corridor (typically < 10–15 hectares) while campus-wide civil packages await EIA finalization. This ring-fencing approach contains statutory environmental risk to the transmission interface, preserving capital optionality for the broader multi-hundred-hectare data campus.
Isolate substation and transmission civil works packages under separate, standalone permitting envelopes from the primary data hall campus.
Negotiate flexible commercial operation date (COD) adjustment windows within TSO Interconnection Agreements tied to environmental permitting milestones.
Establish internal capital gating: limit site preparation expenditure to reversible activities until the EIA Administrative Record of Decision is signed.
Actionable Site Readiness Framework: Reversible Engineering, Phased Clearing, and Transparent Regulatory Audits
To reconcile rapid hyperscale deployment with statutory environmental mandates, engineering organizations must codify a 'Reversible Engineering' framework for all pre-construction activities. Reversible engineering strictly limits site modifications to interventions that can be remediated to natural baselines within one growing season if permits are denied. This protocol accommodates low-impact soil mechanics assessments, static cone penetration tests (CPT), environmental sensor deployment, and temporary boundary demarcation, while categorically prohibiting clearcut logging, stump grubbing, rock blasting, and bulk cut-and-fill operations.
Civil execution must be segmented into micro-zoned clearance phases triggered only by explicit regulatory releases. Instead of clearing 300 hectares simultaneously, the master site plan should divide the campus into discrete 20- to 50-hectare phases aligned with modular data hall deployment schedules. Each phase must undergo joint audits with municipal building-control authorities, regional environmental bodies (ELY Centres/LVV), and indigenous land-use monitors, verifying that drainage controls, ecological buffer zones, and legal stay deadlines are rigorously maintained before any heavy civil mobilization occurs.
Classify all preliminary civil works into explicit categories: Tier 1 (Reversible/Surveys Allowed) vs. Tier 2 (Irreversible/Permit-Gated).
Subdivide gigawatt-scale master plans into phased micro-zones, limiting continuous clearing envelopes to the immediate phase's building footprint.
Institute mandatory bi-weekly compliance audits with local licensing authorities and independent environmental monitors during all active civil phases.
